Takt time is the heartbeat of efficient production. It replaces guesswork in planning with a precise calculation that tells your team exactly how fast they need to work to meet customer demand. By operating in sync with your customers, your factory can create a smooth, steady flow that minimizes waste, avoids shortages and overstock, and maximizes productivity.
In this comprehensive guide, we’ll explore what takt time is, trace its fascinating origins from World War II Germany to modern lean manufacturing, show you how to calculate it with real-world examples, and provide practical strategies for implementation and troubleshooting.
Takt time is the maximum allowable time to produce one unit of product to meet customer demand. The term establishes the rhythm at which your production line must operate to satisfy customer orders without overproducing or falling behind.
The word "takt" derives from the German word "taktzeit," which translates to "cycle time" or "beat." This linguistic origin reflects the concept's European manufacturing heritage, though it's important to recognize that takt time and cycle time represent fundamentally different metrics. We'll examine this critical distinction in detail later in this guide.
Takt time functions as a customer-driven metric, calculated from actual demand rather than production capability. It serves as both a planning tool and a mechanism for waste elimination, providing a common reference point for distributing work evenly across production stations. The formal definition expresses takt time as available production time divided by customer demand.
Takt time originated in Germany's aircraft industry during the 1920s. Hugo Junkers implemented "Takte" (cycle intervals) to synchronize aircraft subassembly delivery with main production line requirements. During World War II, the German Luftwaffe standardized this Taktsystem across military production. The Henschel und Sohn factory famously used takt stations for Tiger I tank production, with each station allocated exactly six hours before the tank advanced to the next stage.
After the war, Toyota's CEO Kiichiro Toyoda recruited aircraft engineers who brought these concepts from Germany to Japan. Taiichi Ohno, architect of the Toyota Production System, refined takt time into a core lean manufacturing principle. Ohno emphasized matching production pace to customer demand rate rather than maximizing speed, recognizing that overproduction amplified all other forms of manufacturing waste.
As lean manufacturing spread globally from Toyota during the 1980s and 1990s, takt time became foundational in production management worldwide. The methodology expanded from automotive manufacturing into electronics, aerospace, pharmaceuticals, and eventually service operations. Modern digital manufacturing systems now automate takt time calculations for production scheduling, real-time monitoring, and capacity planning.
This is the net time available for production during your planning period (typically one shift or one day). Available production time includes actual running time and expected downtime such as machine breakdowns and minor stoppages. It excludes scheduled breaks and lunch periods, shift changeovers, planned maintenance windows, and scheduled meetings or training.
Consider an example calculation. An eight-hour shift equals 480 minutes. Subtract a 10-minute break to yield 470 minutes. Subtract a 20-minute lunch to yield 450 minutes. Subtract a 30-minute planned changeover to yield 420 minutes. The available production time equals 420 minutes.
The distinction between included and excluded time proves critical for accurate takt time calculation. Organizations frequently overestimate available time by failing to account for all legitimate non-production activities, then face persistent schedule shortfalls when reality proves less generous than planning assumptions.
Customer demand represents the number of units customers require during your planning period. This figure can derive from actual customer orders, forecasted demand, production targets based on inventory levels, or averaged demand over longer periods such as weeks or months.
The choice of demand figure affects takt time stability and operational practicality. Using daily order quantities creates takt times that vary day-to-day, potentially requiring frequent line rebalancing. Averaging demand over weekly or monthly periods creates more stable takt times but may result in temporary overproduction or underproduction as actual daily demand fluctuates around the average.
Most manufacturers employ hybrid approaches, using averaged demand for line design and capacity planning while adjusting targets periodically to reflect actual order patterns. The appropriate averaging period depends on demand volatility, product mix complexity, and production flexibility.

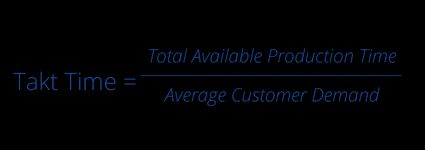

Using our example numbers where available production time equals 420 minutes and customer demand equals 210 units:
Takt Time = 420 minutes ÷ 210 units = 2.0 minutes per unit
This result means your production line must complete one unit every 2 minutes to meet customer demand. The calculation establishes a maximum allowable cycle time—any operation taking longer than 2 minutes per unit will prevent the line from meeting demand unless compensated by faster cycle times elsewhere or by adding capacity.
This takt time calculation is functional because it connects customer demand directly to production pace, removing guesswork about required production speed. The takt time provides a clear target for each workstation and shows when demand increases (takt time decreases, requiring faster production) or decreases (takt time increases, allowing slower production pace).
When demand increases from 210 to 240 units while available time remains 420 minutes, takt time decreases from 2.0 minutes to 1.75 minutes per unit. This 12.5 percent reduction signals that production must accelerate proportionally. Conversely, when demand decreases to 180 units, takt time increases to 2.33 minutes per unit, indicating production can proceed at a more relaxed pace.
The takt time serves not as a rigid constraint but as a planning target that informs capacity decisions, line balancing efforts, and performance monitoring. Organizations operating slightly faster than takt time maintain buffer capacity to handle disruptions, while those operating significantly faster than takt time may face overproduction issues requiring inventory buildup or capacity reallocation.
An automotive parts manufacturer produces brake assemblies during an eight-hour shift. The shift includes a 30-minute lunch period and two 10-minute breaks totaling 20 minutes. A planned changeover consumes 10 minutes. Customer orders require 120 brake assemblies per shift.
Calculate available production time. Start with 480 minutes for the eight-hour shift. Subtract 30 minutes for lunch, 20 minutes for breaks, and 10 minutes for changeover. The available production time equals 420 minutes.
Apply the takt time formula. Divide 420 minutes by 120 units to yield 3.5 minutes per unit.
Interpret the result. The production line must complete one brake assembly every 3.5 minutes to meet customer demand. If actual cycle time equals 5 minutes per unit, production will fall short by approximately 30 percent, completing only 84 units instead of the required 120 units. If actual cycle time equals 3 minutes per unit, the line produces 140 units, creating 20 units of excess inventory and risking overproduction waste.
This example illustrates the importance of matching cycle time to takt time. Cycle times significantly exceeding takt time reveal capacity shortfalls requiring immediate attention. Cycle times falling well below takt time suggest excess capacity that might be redeployed elsewhere or indicate risk of overproduction if production control systems fail to prevent excess output.
An electronics manufacturer operates two shifts producing circuit boards, with weekly demand of 2,400 units across five operating days. Each eight-hour shift allocates 40 minutes for breaks and 20 minutes for changeovers.
Calculate available time per shift: 480 minutes minus 40 minutes for breaks minus 20 minutes for changeovers equals 420 minutes per shift.
Calculate total available time per week: 420 minutes multiplied by 2 shifts multiplied by 5 days equals 4,200 minutes per week.
Apply the takt time formula: 4,200 minutes divided by 2,400 units equals 1.75 minutes per unit.
An alternative approach calculates per-shift demand. Daily demand equals 2,400 units divided by 5 days, or 480 units per day. Demand per shift equals 480 units divided by 2 shifts, or 240 units per shift. This yields the same result: 420 minutes divided by 240 units equals 1.75 minutes per unit.
This example demonstrates that takt time calculation can proceed from different time horizons and still yield consistent results. Whether calculating weekly, daily, or per-shift takt time, the fundamental relationship between available time and required output remains constant. Organizations typically choose calculation periods matching their planning cycles and demand visibility horizons.
A manufacturer produces three different models on the same production line with 450 minutes of available time. Model A requires 100 units at 2 minutes per unit, Model B requires 50 units at 3 minutes per unit, and Model C requires 30 units at 4 minutes per unit.
For weighted average takt time, sum total demand: 100 plus 50 plus 30 equals 180 units. Average takt time equals 450 minutes divided by 180 units, or 2.5 minutes per unit.
Individual product takt times can also be calculated. Model A would receive 4.5 minutes per unit (450 divided by 100), though its actual process time is only 2 minutes. Model B would receive 9.0 minutes per unit, and Model C would receive 15.0 minutes per unit. In mixed-model production, manufacturers typically employ level loading techniques to smooth production across the shift rather than producing in large batches.
Level loading for this scenario might sequence production as A-A-B-A-A-C-A-A-B-A-A-C, distributing the three models proportionally throughout available time. This sequence maintains steadier overall pace than producing all Model A units first, then all Model B units, then all Model C units. The steady pace reduces work-in-process buildup, makes quality problems visible sooner, and creates more predictable material consumption patterns.
In a perfect Lean environment, the relationship between these three metrics follows a hierarchy that maximizes ROI and eliminates waste:
Cycle Time ≤ Takt Time: Your actual work speed should be roughly 90–95% of Takt Time, providing a small buffer for minor interruptions without failing to meet customer demand.
Minimized Lead Time: Lead Time should be as close as possible to the sum of your Cycle Times. For example, if total Cycle Time is 1 hour but Lead Time is 10 days, 99% of the product’s time is idle, representing pure waste.
Takt time functions as more than a calculation. It represents a fundamental operating principle that transforms manufacturing execution from reactive scheduling to demand-synchronized production.
Production systems operating without takt time typically run at maximum achievable speed, independent of actual demand signals. This approach generates inventory during periods of low demand and creates capacity shortages when demand increases. The disconnect between production pace and order rate leads to resource misallocation and suboptimal working capital deployment.
Takt time establishes direct alignment between order rate and production pace. When demand changes, the calculated takt time changes proportionally, triggering controlled adjustments to production resources. This synchronization maintains lean inventory levels while meeting delivery commitments.
Overproduction amplifies other forms of manufacturing waste. Excess production requires additional handling, consumes storage capacity, ties up working capital, and increases the inventory at risk from quality issues or obsolescence. Organizations often underestimate the compounding effect of overproduction on total manufacturing cost.
Takt time establishes a maximum production rate derived from actual demand. Production exceeding this rate generates inventory that customer orders have not yet justified. Pull-based production systems use takt time as the foundation for inventory replenishment signals, preventing unauthorized production while maintaining buffer stock at calculated levels.
Manufacturing lines develop bottlenecks when workstation cycle times vary significantly. Slow stations create waiting at downstream operations, fast stations create waiting at upstream operations, and both conditions generate work-in-process inventory that obscures quality issues and extends lead time.
Takt time provides a common target for balancing workload across all stations. When each station operates near the calculated takt time, flow improves and waiting decreases. Line balancing efforts use takt time as the reference point for redistributing work elements across stations.
Consider a three-station line before balancing. Station 1 completes work in 1.5 minutes, Station 2 requires 3.5 minutes, and Station 3 completes in 2.0 minutes. The bottleneck at Station 2 limits throughput while Stations 1 and 3 accumulate idle time. After balancing to a 2.5-minute takt time, Station 1 performs work totaling 2.3 minutes, Station 2 completes 2.4 minutes of work, and Station 3 handles 2.3 minutes. Flow improves and bottleneck waiting largely disappears.
Takt time quantifies the relationship between demand and required capacity. When cycle time exceeds takt time, analysis immediately reveals whether additional operators, additional shifts, faster equipment, or process improvement can close the gap. When cycle time falls well below takt time, excess capacity becomes visible and can be redeployed.
Staffing requirements derive from the comparison between takt time and cycle time. Equipment investment decisions gain quantitative support when takt time analysis demonstrates that current equipment cannot achieve required cycle times. Capacity planning validates whether demand projections require facility expansion or whether existing assets suffice.
Takt time establishes a clear baseline for improvement initiatives. The gap between current cycle time and required takt time quantifies the improvement target. Kaizen events and process optimization efforts use this gap to prioritize activities and measure progress.
The improvement cycle follows a standard pattern. Measure current cycle time and compare to takt time. Identify root causes for the gap. Implement improvements addressing these causes. Validate the new cycle time. Document the process and repeat. This structured approach replaces ad hoc improvement with systematic capability building.
Operating at sustainable pace rather than maximum speed affects both quality outcomes and safety performance. Production systems pushed to maximum throughput often sacrifice quality checks, proper technique, and ergonomic considerations. The pressure to maintain speed creates conditions where errors multiply and injuries occur.
Takt time–based production operates at a pace that supports proper work methods, allows time for quality verification at each station, and reduces the physical stress associated with rushing. Manufacturing operations report substantial reductions in defects when transitioning from maximum-speed production to takt time–based production. Similarly, safety incident rates decline when operators work at a sustainable pace rather than pushing to maximum achievable speed.
While understanding the theory behind takt time is important, putting it into practice requires the right tools and approach. FlowFuse provides an industrial automation platform that connects to your existing systems—whether that's PLCs, databases, or ERP software—to automatically calculate and monitor takt time in real-time.
Instead of manually calculating takt time on spreadsheets or relying on static reports, you can build a dynamic monitoring system that updates continuously as customer orders and production conditions change. Let's see how it works, but before we begin, make sure you have a FlowFuse instance running. You can create an account here and get it set up quickly.
The foundation of accurate takt time calculation is reliable data. FlowFuse supports connections to virtually any industrial system through its extensive library of protocol and database nodes.
In a real implementation, you would pull customer order data from your ERP system, gather production schedules from manufacturing execution systems, connect to PLCs for real-time production counts, and integrate with quality systems for good parts tracking. You can pull customer order data from your ERP system using FlowFuse's integration capabilities.
For this demonstration, we'll simulate customer orders using an Inject node:
Add an Inject node
Configure the payload with this JSONata expression:
$round($random() * 50 + 50)
Set it to trigger every 5 seconds
This simulates variability in customer demand between 50 and 100 units.
Next, establish the available production time for your shift. This typically equals your total shift hours minus planned downtime for breaks, maintenance, and changeovers.
Add a Change node
Use the following JSONata expression:
(8 * 60) - 60
This represents an 8-hour shift (480 minutes) minus 1 hour (60 minutes) for breaks and changeovers, giving 420 minutes of available production time.
Data is most valuable when operators can interpret it instantly on the shop floor. FlowFuse's dashboard lets you create real-time displays using the same intuitive drag-and-drop interface.
Install the FlowFuse Dashboard package via the Palette Manager (@flowfuse/node-red-dashboard)
For basic displays, use text widgets to show current takt time values. For more sophisticated interfaces, the Template widget allows you to create custom components. With FlowFuse AI, you can describe your desired interface in plain English and let the AI generate the appropriate code
Connect the output of the Inject node to the input of the Change node that calculates available production time. Next, connect the output of this Change node to the input of the Change node that calculates takt time. Finally, connect the output of the takt time Change node to the input of the UI Template node

Next, deploy the flow and open the dashboard to see real-time takt time updates
Real-time takt time monitoring dashboard in FlowFuse
Here's the complete flow we built for automated takt time calculation and visualization with FlowFuse.
While you now know how to calculate takt time and use it to guide production, it isn’t always the right tool. Certain production environments and situations call for alternative approaches. Recognizing these limitations prevents misapplication and ensures your efforts focus on the most suitable methodologies.
Demand variability exceeding 200 to 300 percent between periods makes takt time impractical as a daily operating metric. Recalculating takt time multiple times per shift creates confusion rather than clarity, and operators cannot reasonably adjust their pace to accommodate such variation.
In these situations, organizations typically calculate takt time using averaged demand over longer periods—weekly or monthly rather than daily or per shift. The resulting takt time informs capacity planning and equipment decisions but provides less value for shop floor execution. Alternative approaches such as queue management, dynamic scheduling, or theory of constraints methods may prove more practical.
Steel mills, chemical plants, refineries, and similar continuous process operations produce flowing streams of material rather than discrete countable units. While throughput rate concepts analogous to takt time apply, the standard takt time calculation and visualization methods designed for discrete manufacturing translate poorly to continuous operations.
These operations typically employ flow rate metrics, comparing actual flow rates to required flow rates based on demand. Capacity analysis and bottleneck management follow different methodologies more suited to continuous process characteristics.
Job shops and custom manufacturing operations where process time for different products varies by factors of five or ten face practical difficulties implementing takt time at the workstation level. A single takt time cannot accommodate such variation, and calculating separate takt times for each product family may create dozens of different targets.
These environments often benefit more from focusing on lead time reduction, improving flow efficiency, and implementing theory of constraints to manage bottlenecks. Takt time may inform capacity planning at the facility level while playing minimal role in daily execution.
Shipbuilding, large construction projects, aerospace programs, and similar endeavors produce unique products without repetitive cycles. The concept of average time per unit has limited meaning when only one unit exists or when units differ substantially from each other.
Project management methodologies typically serve these environments better than takt time approaches. Critical path analysis, milestone tracking, and resource leveling address the planning and execution challenges these operations face.
Product development, prototyping, and ramp-up activities involve learning curves, process refinement, and frequent changes. Establishing takt time targets during these phases creates false precision and may drive counterproductive behavior such as rushing through development stages that require thorough exploration.
Development activities typically require cycle time measurement and improvement tracking, but formal takt time targets come into play only after processes stabilize and demand patterns become predictable. Organizations implementing takt time too early in product lifecycles often abandon it when targets prove unachievable, creating skepticism about the methodology.
Equipment repair, facility maintenance, and similar unscheduled activities respond to emergent needs rather than predictable demand. Work content varies based on actual conditions encountered, and forcing these operations into takt time frameworks typically generates gaming behavior or artificial standardization that compromises quality.
Maintenance operations generally employ backlog management, priority systems, and response time tracking rather than takt time metrics. Preventive maintenance schedules may use time-based standards, but these derive from equipment requirements rather than external demand signals.
Analytical laboratories, quality testing facilities, and research operations perform work whose duration depends on test requirements, sample characteristics, and analytical methods. Demand for testing services may follow patterns, but the work content per sample can vary substantially.
These operations typically track turnaround time from sample receipt to result reporting, backlog levels, and equipment utilization. While throughput management concepts apply, standard takt time implementation often fits poorly with operational realities.
Calculating takt time requires only basic arithmetic. Sustaining takt time-based production on the shop floor requires addressing systematic obstacles that emerge during implementation.
When current cycle time exceeds calculated takt time, production cannot meet customer demand at existing capacity. This condition requires immediate attention to prevent order backlog accumulation.
Begin by identifying the constraint—the slowest operation in your process chain determines overall throughput capacity. Time studies at each workstation reveal where cycle time exceeds takt time most significantly. Process observation identifies whether the constraint results from equipment limitations, operator skill gaps, material flow issues, or quality problems causing rework.
Short-term responses include adding operators to constrained workstations, implementing parallel processing where feasible, or extending available production time through additional shifts or overtime. These approaches address immediate capacity shortfalls while preserving time for systematic improvement.
Long-term solutions require process optimization. Conduct detailed value stream mapping to identify non-value-added activities within the constraint operation. Implement work standardization to establish consistent methods across operators. Consider equipment upgrades or automation where manual processes cannot achieve required cycle times. Redesign workstations to improve ergonomics and material presentation, reducing wasted motion and search time.
Customer orders rarely arrive at perfectly steady rates. Order patterns typically show daily, weekly, and seasonal variation. When this variation remains moderate—perhaps plus or minus 20 percent around average—periodic takt time recalculation suffices. When variation reaches 100 percent or more, continuous takt time adjustment becomes impractical.
Calculate separate takt times for peak demand periods, average demand periods, and minimum demand periods. Design staffing models that accommodate each scenario through flexible labor deployment. Cross-train operators to shift between production lines or work centers as demand patterns change. High-volume operations may maintain dedicated crews for each demand scenario, while smaller operations typically rely on temporary labor or overtime during peaks.
Integrate takt time calculations with ERP or MES systems to enable automatic target adjustment as new orders arrive. This integration prevents the common problem of operating to outdated takt times when demand shifts. Configure exception alerting to notify supervision when demand changes exceed predefined thresholds requiring immediate response.
Production lines running several different product types face the question of whether to use separate takt times for each product or a single averaged takt time. The answer depends on process similarity and demand stability.
For products with similar processing requirements and roughly proportional demand, calculate weighted average takt time. Weight each product's takt time by its volume contribution to total demand. This approach yields a single target that approximates appropriate pace across the product mix.
For products differing substantially in processing requirements, implement pitch—takt time multiplied by standard container quantity. If takt time equals 2 minutes and standard containers hold 10 units, pitch equals 20 minutes per container. This modification maintains production rhythm while accommodating per-unit variation. Operators work to complete containers on pitch intervals rather than individual units on takt intervals.
Level loading becomes essential in mixed-model production. Rather than producing day one's demand for Product A in the morning and day two's demand for Product B in the afternoon, sequence products to distribute variety evenly across available time. The sequence A-B-A-B-A-B maintains steadier pace than A-A-A-B-B-B, even though both sequences produce the same total output.
Takt time calculations assume some level of equipment downtime, but actual downtime exceeding these assumptions creates systematic schedule shortfalls. Organizations commonly plan available time using optimistic downtime estimates, then face persistent underproduction when reality proves harsher.
Calculate available time using realistic downtime rates based on historical performance data. If your line averages 10 percent unplanned stops, use 432 minutes of a 480-minute shift when calculating takt time rather than assuming perfect reliability. This adjustment builds appropriate buffer into planning.
Address root causes of chronic equipment problems through total productive maintenance programs. Establish routine preventive maintenance schedules based on manufacturer recommendations and operating experience. Maintain critical spare parts inventory for high-impact components prone to failure. Train operators in basic troubleshooting to reduce downtime from minor issues that require no specialized expertise.
Implement condition monitoring where appropriate to predict failures before they occur. Vibration analysis, thermal imaging, and oil analysis provide advance warning of degrading conditions, allowing planned maintenance during scheduled downtime rather than emergency repair during production time.
Poor first-pass yield diminishes effective production capacity even when cycle times meet takt time targets. If operations complete one unit every 2 minutes but 10 percent fail quality inspection, effective cycle time increases to 2.22 minutes per good unit.
Account for known yield losses when calculating available production time. Multiply available time by expected yield before dividing by demand. If yield equals 95 percent, multiply 450 minutes by 0.95 to yield 427.5 effective minutes. This adjustment sets realistic production targets.
The superior approach eliminates yield losses through error-proofing and process control. Install verification sensors at critical operations to detect defects before they propagate downstream. Implement poka-yoke devices to prevent common error modes. Apply statistical process control to maintain operations within specification limits. Each percentage point of yield improvement translates directly into capacity gain.
Operators require time to develop proficiency with new products or new processes. Learning curves show that initial cycle times typically run 150 to 200 percent of eventual steady-state times, then improve as operators gain experience and identify optimization opportunities.
Set initial takt time targets at 150 percent of calculated steady-state requirements during ramp-up phases. Monitor actual cycle time performance weekly and tighten targets as capabilities improve. This graduated approach maintains achievable targets while building toward full-rate production.
Run pilot batches before full production launch to refine processes and develop operator training programs. Select experienced operators for initial production runs, allowing them to identify issues and develop countermeasures before expanding to full crew. Document lessons learned and incorporate improvements into standard work instructions before broader rollout.
Production teams require continuous feedback to maintain takt time pace. Discovering at shift end that production fell short provides no opportunity for in-shift correction. Hourly or more frequent status updates enable teams to identify emerging problems while time remains to recover.
Implement visual management systems displaying current output versus target on the shop floor. Use color-coded status indicators that immediately communicate performance status without requiring numerical interpretation. Configure alerts when production falls below threshold levels—typically 10 percent behind pace triggers attention.
Deploy hourly production boards that segment the shift into discrete intervals. Rather than working toward an end-of-shift target of 200 units, operators work toward 25 units per hour across an eight-hour shift. This granularity makes deviations visible early and converts abstract targets into concrete near-term goals.
Recognize environments where takt time application creates more problems than it solves. Continuous process industries operating steel mills, refineries, or chemical plants typically derive little value from discrete-unit takt time concepts. Throughput rate management serves these operations better.
Job shops experiencing extreme process time variation—200 to 300 percent between different parts—struggle to implement meaningful takt time at the workstation level. These environments benefit more from lead time reduction initiatives and theory of constraints approaches to bottleneck management.
Calculate takt time at higher organizational levels in these situations. Weekly production targets rather than hourly takt times may provide appropriate planning frameworks. Focus on overall system flow rather than rigid station-by-station takt compliance.
Accurate Data: Base takt time on actual production time, including breaks, changeovers, maintenance, and realistic downtime. Use real customer demand and update regularly.
Leadership Commitment: Leaders must support implementation visibly, allocate resources, participate in training, and communicate the benefits clearly.
Gradual Deployment: Start with a pilot line, train operators, stabilize each phase, and expand gradually. Avoid implementing across all lines at once.
Lean Integration: Combine takt time with value stream mapping, standardized work, and 5S to reduce waste and improve process capability.
Visual Management: Use intuitive, visible displays that show production status at a glance, enabling quick operator action.
Problem Response: Establish escalation procedures, maintain critical spares, station maintenance nearby, and train operators in basic troubleshooting.
Continuous Refinement: Review takt time regularly, analyze performance trends, and share lessons learned to improve future deployments.
Takt time is the essential "heartbeat" of lean manufacturing, transforming volatile customer demand into a precise, manageable production rhythm. While the formula is mathematically simple, its implementation is what separates world-class operations from those plagued by overproduction and constant firefighting.
By synchronizing your production pace with the market, you expose bottlenecks, balance workloads, and create a predictable flow that maximizes resource utilization. However, manual tracking often leads to lagging data and missed opportunities. Modern industrial platforms like FlowFuse bridge this gap, providing the real-time visibility needed to monitor Takt, Cycle, and Lead times automatically across your entire value stream.
Mastering Takt Time isn't just about working faster—it's about working smarter by ensuring every minute on the shop floor creates value for the customer.
Book your demo today to see how FlowFuse can automate your production metrics and help you eliminate waste through real-time data visibility.
Frequently Asked Questions
What is the difference between takt time and cycle time?
Takt time is the rate at which products must be completed to meet customer demand, while cycle time is the actual time it takes to complete one unit. Takt time is based on customer requirements, whereas cycle time measures your current production capability. Ideally, cycle time should be equal to or slightly less than takt time to meet demand without overproducing.
How do I calculate takt time if customer demand varies throughout the day?
For variable demand, calculate takt time for specific time periods or use average demand over a meaningful timeframe. You can also calculate multiple takt times for different shifts or production windows. FlowFuse allows you to monitor these variations in real-time and adjust production pace accordingly.
What should I do if my cycle time is longer than my takt time?
If cycle time exceeds takt time, you're unable to meet customer demand. Solutions include adding more workers, improving processes to reduce cycle time, extending available production hours, or investing in faster equipment. You may also need to analyze bottlenecks in your production line.
Does takt time include downtime and breaks?
No, takt time is calculated using available production time, which excludes planned downtime such as breaks, maintenance, shift changes, and scheduled meetings. This gives you a realistic production pace that accounts for these necessary interruptions.
Can takt time be used in non-manufacturing environments?
Yes, takt time principles apply to any process with customer demand and capacity constraints. Service industries, healthcare facilities, software development teams, and logistics operations can all benefit from understanding the pace needed to meet customer requirements.
How often should I recalculate takt time?
Recalculate takt time whenever customer demand changes significantly or when available production time is modified. With FlowFuse, this calculation happens automatically in real-time, ensuring your production pace always aligns with current demand.
What's the difference between takt time and lead time?
Takt time is the pace at which you need to produce to meet demand, while lead time is the total time from customer order to delivery. Lead time includes processing time, waiting time, transportation, and all other delays. Takt time focuses specifically on production rhythm.
Is a lower takt time always better?
Not necessarily. A lower takt time means higher demand and faster required production pace, which can strain resources. The goal isn't to minimize takt time but to match it with your cycle time, creating a balanced production system that meets demand without waste.
How does takt time relate to lean manufacturing?
Takt time is a fundamental concept in lean manufacturing. It helps eliminate waste by preventing overproduction, balancing workloads across stations, and creating a steady production flow. It's often used alongside other lean tools like value stream mapping and continuous improvement initiatives.
Can I use takt time for batch production?
Yes, but you'll need to adjust your calculation. For batch production, consider the total units in a batch and the frequency of batch production. Calculate how many batches you need within your available time to meet customer demand, then determine the takt time per batch.
About the Author
Sumit Shinde
Technical Writer
Sumit is a Technical Writer at FlowFuse who helps engineers adopt Node-RED for industrial automation projects. He has authored over 100 articles covering industrial protocols (OPC UA, MQTT, Modbus), Unified Namespace architectures, and practical manufacturing solutions. Through his writing, he makes complex industrial concepts accessible, helping teams connect legacy equipment, build real-time dashboards, and implement Industry 4.0 strategies.
